Restoration and renewal of the Palace of Westminster

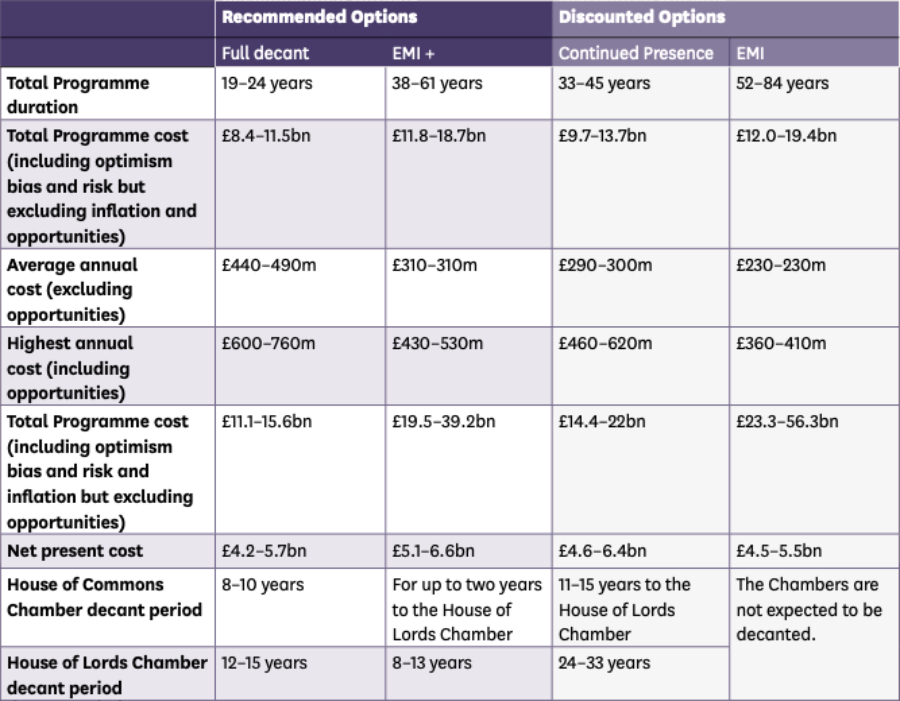

On 5 Februrary, 2026 the UK Parliament published the report "Delivering restoration and renewal of the Palace of Westminster: the costed proposals
- 2026: Delivering restoration and renewal of the Palace of Westminster: the costed proposals published.
- 2023: A new two-tier governance structure (Client Board and Program Board) was established, with the Programme Board meeting for the first time in February 2023.
- 2022: Review completed and restructuring announced to replace the initial sponsor governing body.
- 2020: National Audit Office reports and Public Accounts Committee review project.
- 2019: The Parliamentary Buildings (Restoration and Renewal) Act 2019 received Royal Assent.
- 2018: Major restoration of the Elizabeth Tower (Big Ben).
- 2017: Parliament decides in principle to proceed with a full restoration.
- 2016: Joint Committee report recommended a full decant
- 2015: Independent Options Appraisal published.
- 2013: Initial establishment of the programme.
- 1990-1994: Restoration of the Victoria Tower, the tallest tower in the Palace.
- 1982 - 1990: Stone cleaning and restoration of north, west, south and River fronts.
- 1981-1982: Major stone cleaning and restoration programme starts with New Palace Yard.
- 1941–1950: Rebuilding of the Commons Chamber following destruction in the Blitz.
- 1849 - Defects in the choice of stone became apparent, experiments with various compositions on stone
- 1847 - The Lord's Chamber completed
- 1840–1870: Construction of the current Palace by Charles Barry after the 1834 fire. Only Westminster Hall, the Undercroft Chapel, the Cloisters and Chapter House of St Stephen's and the Jewel Tower survived.
- 1834 - The Great Fire destroys most of Palace
The Palace of Westminster was almost completely destroyed by the 'tally-stack' fire of 16 October.
1847 - The Lord's Chamber completed
1849 - Defects in the choice of stone became apparent
Barry experiments with various compositions on the stone
1852 - The Common's Chamber completed
... and Charles Barry was knighted
1859 - Big Ben installed in the Clock Tower
1860 - Victoria Tower completed
1870 - The rebuilding of the Palace completed
1883 - Electric lighting installed in the House of Lords
1912 - Electric lighting installed in the House of Commons
1920 - A large fragment of stone fell from the Victoria Tower
1936 - Restoration work of Victoria Tower
Scaffolding was erected around the Victoria Tower so that restoration work could begin. This was halted during the Second World War
1940-1 - Both Houses of Parliament sometimes sat in Church House in Westminster Abbey
This was due to fear of wartime bombing raids
11 May 1941 - The Commons Chamber destroyed on the last day of the Blitz
The Commons consequently met in the Lords Chamber until 1950 while the Lords met in the Robing Room
1943 - Architect appointed for rebuild of chamber
The Commons decided that its new chamber should be designed on similar lines to the old. The architect Sir Giles Gilbert Scott was appointed to undertake the work.
1948 - Foundation stone of new Commons Chamber laid
1950 - The new Commons Chamber first used on 26 October
1950s - Work on the exterior of the Victoria Tower finally completed
1951 - The House of Lords returns to its Chamber on 29 May
1971 - Working group set up to offer advice on restoration
Pollution was again taking its toll
1981 - A major restoration programme begun over several phases
1990-4 - Victoria Tower restored
2000 - Portcullis House completed
A new Parliamentary building was completed
Featured articles and news
Building Safety recap January, 2026
What we missed at the end of last year, and at the start of this...
National Apprenticeship Week 2026, 9-15 Feb
Shining a light on the positive impacts for businesses, their apprentices and the wider economy alike.
Applications and benefits of acoustic flooring
From commercial to retail.
From solid to sprung and ribbed to raised.
Strengthening industry collaboration in Hong Kong
Hong Kong Institute of Construction and The Chartered Institute of Building sign Memorandum of Understanding.
A detailed description fron the experts at Cornish Lime.
IHBC planning for growth with corporate plan development
Grow with the Institute by volunteering and CP25 consultation.
Connecting ambition and action for designers and specifiers.
Electrical skills gap deepens as apprenticeship starts fall despite surging demand says ECA.
Built environment bodies deepen joint action on EDI
B.E.Inclusive initiative agree next phase of joint equity, diversity and inclusion (EDI) action plan.
Recognising culture as key to sustainable economic growth
Creative UK Provocation paper: Culture as Growth Infrastructure.
Futurebuild and UK Construction Week London Unite
Creating the UK’s Built Environment Super Event and over 25 other key partnerships.
Welsh and Scottish 2026 elections
Manifestos for the built environment for upcoming same May day elections.
Advancing BIM education with a competency framework
“We don’t need people who can just draw in 3D. We need people who can think in data.”
Guidance notes to prepare for April ERA changes
From the Electrical Contractors' Association Employee Relations team.
Significant changes to be seen from the new ERA in 2026 and 2027, starting on 6 April 2026.
First aid in the modern workplace with St John Ambulance.
Solar panels, pitched roofs and risk of fire spread
60% increase in solar panel fires prompts tests and installation warnings.
Modernising heat networks with Heat interface unit
Why HIUs hold the key to efficiency upgrades.
