The Complete Guide to ISO 19650 for Architecture Firms (2026)
Contents |
[edit] What is ISO 19650?
ISO 19650 is an international standard published by the International Organization for Standardization (ISO) that defines how information should be managed across the full lifecycle of a built asset using Building Information Modelling (BIM). It is not a software standard — it does not mandate any particular tool. Instead, it establishes the processes, roles, and responsibilities around information creation, review, sharing, and storage on construction projects.
Originally derived from the UK's PAS 1192 framework, ISO 19650 is now adopted globally — with national annexes in Europe, the Middle East, Asia-Pacific, and the Americas. For architects, contractors, consultants, and developers operating in the USA, UK, and Middle East, compliance is increasingly a baseline requirement for public sector work and large private developments.
== Structure of the standard
==
ISO 19650 is published in five parts, each covering a distinct phase or aspect of information management:
- Part 1 — Concepts and principles. The foundation for all other parts; applicable to every member of the project team.
- Part 2 — Delivery phase. Covers information management during design and construction; the most widely referenced part in practice.
- Part 3 — Operational phase. Addresses asset management and facility management after handover.
- Part 4 — Information exchange. Defines data formats and interoperability requirements.
- Part 5 — Security-minded approach. Primarily relevant for public sector and infrastructure projects.
[edit] Key concepts and terminology
- Exchange Information Requirement (EIR) — The appointing party's formal statement of what information is needed, in what format, and at which project milestones. It is the starting point of every ISO 19650-compliant project.
- BIM Execution Plan (BEP) — The lead appointed party's response to the EIR, outlining how information will be produced and managed. Under the proposed 2026 revision, this is expected to be renamed the Information Production Plan.
- Common Data Environment (CDE) — A centralised platform where all project information is stored, versioned, and shared. Common examples include Autodesk BIM 360, Trimble Connect, and Aconex.
- Asset Information Model (AIM) — The structured dataset handed to the building owner at project completion, containing all information needed for the operational life of the asset.
- Status codes — A filing system used to identify the state of every document:
- S0 — Work in progress
- A1 — Shared for coordination
- A4 — Shared for information
- B1 — Shared for authorisation
- C1 — Authorised for stage completion
- Master Information Delivery Plan (MIDP) — The overall schedule of all information deliverables across the project.
- Task Information Delivery Plan (TIDP) — An individual discipline's contribution to the MIDP.
== How ISO 19650 works on a project
==

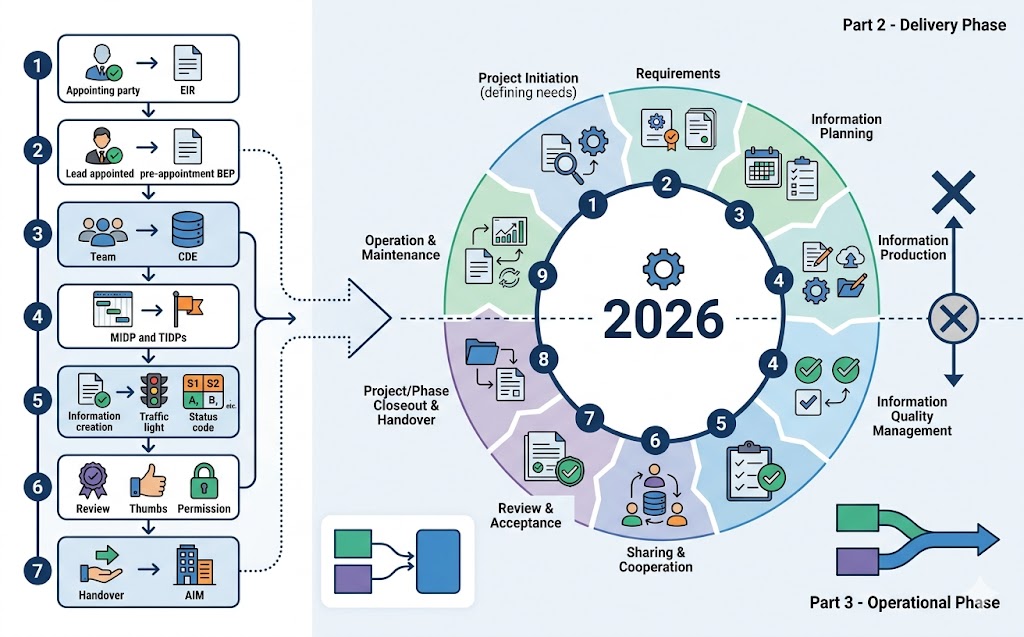

The standard defines a structured sequence of information management activities, broadly following this flow:
- Appointing party issues an EIR setting out information requirements.
- Lead appointed party prepares a pre-appointment BEP in response.
- Post-appointment BEP is finalised and a CDE is established.
- MIDP and TIDPs are agreed, mapping deliverables to project milestones.
- Information is produced, checked, and progressed through status codes within the CDE.
- At each stage, information is reviewed, approved, and authorised before being shared with the wider team.
- At handover, a structured AIM is delivered to the asset owner for operational use.
The 2026 revision proposes merging this process into a single unified 9-step information management cycle covering both delivery and operational phases — removing the formal boundary between Parts 2 and 3.
[edit] 2026 revision — what is changing
A Draft International Standard (DIS) for ISO 19650 Parts 1, 2, and 3 was released for public consultation on 10 March 2026. The final revised standard is expected in 2027. Key proposed changes include:
- A shift in language from "BIM" to "Information Management (IM)" throughout the standard, reflecting a broader lifecycle focus rather than a modelling-centric view.
- Merging of the delivery phase (Part 2) and operational phase (Part 3) into a single, continuous 9-step process covering the entire asset lifecycle.
- Renaming of the BIM Execution Plan (BEP) to the Information Production Plan, with a broader scope.
- Greater emphasis on the appointing party's responsibilities — asset owners must define clear, structured information requirements from the outset.
- Clearer, more accessible language aimed at reducing barriers for smaller firms and those newer to BIM.
- Stronger alignment with digital twin platforms, AI-driven workflows, and ESG reporting requirements.
The 2018 editions of the standard remain in force. Existing certifications are not immediately invalidated, and a transition period is expected after final publication.
[edit] Benefits for architecture firms, contractors, and consultants
Implementing ISO 19650 workflows delivers operational benefits at every stage of a project, regardless of firm size:
- Reduced information retrieval time — Firms following structured naming conventions and status codes have reported up to 45% reduction in time spent locating files during construction.
- Fewer coordination errors — Clear version control and defined CDE workflows prevent teams from working from outdated models.
- Shorter disputes — Defined responsibility matrices reduce ambiguity about who owns each deliverable, limiting the scope for contractual conflicts.
- Scalable onboarding — New staff and subcontractors can be trained faster when they are joining a documented, standardised process rather than learning ad-hoc workflows.
- Global project eligibility — ISO 19650 compliance is a prerequisite on public sector projects in the UK, UAE, Singapore, and Germany, and is increasingly expected by major private developers worldwide.
- Lifecycle data quality — A well-structured AIM at handover reduces operational costs and enables smarter facilities management, energy monitoring, and maintenance planning.
[edit] Adoption by market
| Market | Current status | Primary driver |
| United Kingdom | Mandatory on government-funded projects; widely expected on private sector schemes | UK BIM Mandate, BSI, NBS |
| Middle East (UAE, KSA) | Required on major infrastructure and government programmes | Saudi Vision 2030, UAE government BIM mandates |
| United States | Increasingly requested by federal agencies and large developers; not yet universally mandated | GSA, USACE BIM requirements |
| Europe (Germany, Netherlands) | Mandated or strongly encouraged on public infrastructure projects | EU BIM Task Group guidelines |
[edit] Implementation guidance for architecture firms
The most common implementation mistake is attempting to apply every clause of the standard at once. A more effective and scalable approach is to build compliance progressively:
- Start by auditing your current information management maturity — identify gaps in naming conventions, version control, and file approval workflows.
- Establish a CDE as the single source of truth for all project information, even before formalising other workflows.
- Create a standard BEP template that can be adapted for each project rather than written from scratch each time.
- Define a responsibility matrix for every project at the outset, clarifying which discipline owns each information deliverable.
- Train all team members on status codes — consistent use across the CDE is the single most impactful compliance step for day-to-day workflow.
- Introduce QA checkpoints at each project stage gate, verifying that information is complete and correctly filed before it is shared or authorised.
A five-person practice can gain just as much operational value from a well-implemented CDE and naming convention as a 500-person firm can from a full enterprise information management system. The standard is deliberately designed to scale.
For architecture firms that require structured, ISO 19650-aligned production workflows — particularly those managing large project volumes or working across multiple geographies — architectural BIM modelling and outsourcing services offer a practical route to maintaining compliance without expanding in-house headcount, especially on projects spanning the USA, UK, and Middle East markets.
[edit] Frequently asked questions
- Is ISO 19650 mandatory? It is mandatory on public sector projects in several countries, including the UK. In other markets it is increasingly expected by clients and lead contractors even where not legally required.
- Do small firms need to comply? The standard applies to any firm working on a project where the appointing party has specified ISO 19650 requirements. The principles are fully scalable to firms of any size.
- Is certification required? Certification is not mandatory for all projects, but it provides a verifiable trust signal when bidding for Tier 1 contracts, government work, or cross-border projects in the UK and Middle East.
- What is the difference between BIM and ISO 19650? BIM refers broadly to the use of intelligent digital models in construction. ISO 19650 is the standard that governs how information produced through BIM is managed, shared, and governed across the project lifecycle.
- Will the 2026 revision replace existing certifications? No immediately. The 2018 editions remain in force until the final revised standard is published, expected in 2027, after which a transition period will apply.
BIM Directory
[edit] Building Information Modelling (BIM)
[edit] Information Requirements
Employer's Information Requirements (EIR)
Organisational Information Requirements (OIR)
Asset Information Requirements (AIR)
[edit] Information Models
Project Information Model (PIM)
[edit] Collaborative Practices
Industry Foundation Classes (IFC)
