Expectation management in building design
Contents |
[edit] Expectation management
Expectation management describes a defined approach where specific consideration is given to the anticipated delivery of an item by one party to another. The item being delivered may be almost anything from products to services or roles, with the parties being clients, customers, employers, or employees (for employees, see also Expectancy Theory, V. Vroom, 1964). It is a management approach that relates to conception, briefing, communication, and feedback strategies, which in turn can influence programme progression and ultimately the actual or perceived success of a project, scheme, or building.
[edit] Expectation interest
Expectation interest, more formally, is a legal term sometimes used in construction as one of the two categories of potential damages, the other being reliance expenditure. In quite abstract but legal terms, it might be described as the value to a promisee of a promise, which in practical terms might be the difference between the market value of a property without defects (i.e. where a construction promise or contract has been upheld) and the market value of the property with the defects (where the promise or contract has not).
While the term as used in expectation management is not necessarily directly linked, it may be more relevant if energy performance in use is part of the contractual obligations, which may, for example, be the case in energy performance contracting. In this case, it would need to be argued that the poor energy performance of a building would, under the contract, qualify as a defect, and as such, the definition of poor would most likely need to have been quantified, stated, and agreed upon at the start of the contract.
[edit] Performance gap
It is not clear when the phrase started to be used, particularly in relation to project management, buildings, and construction. However, the growing realisation that end-user expectations needed to be obtained and managed grew out of post-occupancy studies of non-domestic buildings, notably the Post-occupancy Review of Buildings and their Engineering (PROBE) studies carried out between 1995 and 2002 and subsequent building performance evaluation research programmes using the PROBE techniques. In this context, expectation management is most commonly associated with outturn energy performance and levels of occupant satisfaction. Expectations of performance expected by a user, client, or design team need to be assessed and compared with actual measured outcomes, and any disparities investigated and resolved.
Published post-occupancy studies carried out by the PROBE Team, the Carbon Trust (2006–2011), and more recently by InnovateUK (2011–2015) often revealed large differences between what was expected in terms of energy performance and occupant satisfaction and what was delivered. This became popularised as the performance gap. In this context, expectation management is a technique to reduce the risk of performance outcomes diverging from design intentions. It requires reality checks at key procurement gateways, for example, at the project stages as defined by the RIBA Plan for Use (the RIBA's interpretation of the Soft Landings Framework developed following the PROBE studies).

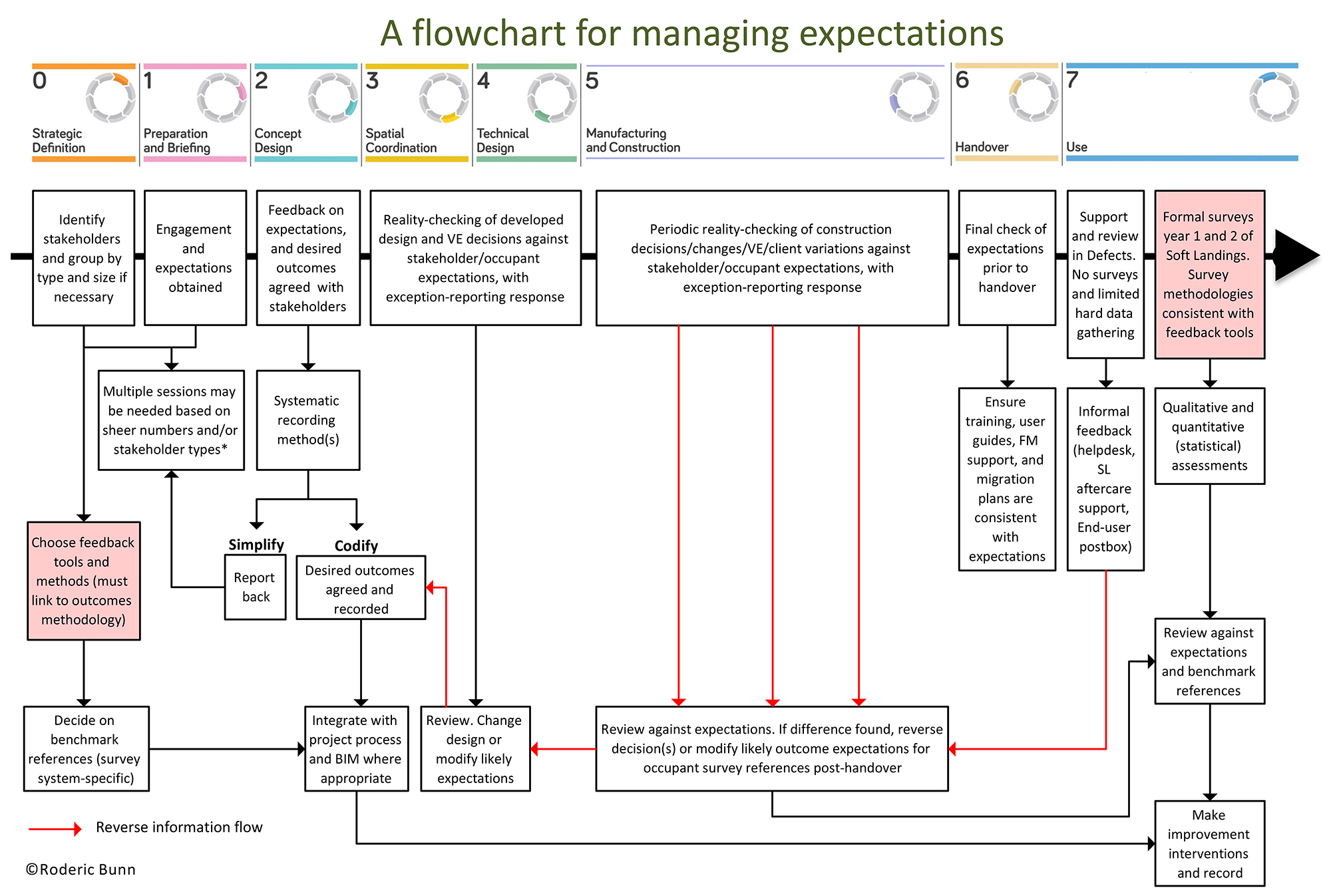

[edit] Managing expectations flowchart for occupant satisfaction
The occupant satisfaction expectations flowchart below shows issues and watch points throughout the various stages of the procurement process. It is aligned with the RIBA Plan of Work stages and the requirements of the RIBA Plan for Use, and helps with delivering the sustainability competence requirements of the Architects Registration Board (2021). This flowchart can be used as guidance for design teams, helping projects create feedback loops within the procurement process, reality-checking design specifications, and therefore managing end-user expectations.
The author, Roderic Bunn, has extensive experience with post-occupancy evaluations. He was a primary author of the definitive edition of the Soft Landings Framework (2014), published jointly by BSRIA and the Usable Buildings Trust (UBT), and authored many supporting guides on Soft Landings. The flowchart provides a process to fill the large gap between early-stage end-user involvement and project handover, during which time design intentions can be compromised by changes in a wide range of project variables. These are often caused by pressures on budget and time, but also by inappropriate value-engineering and price gouging that usually introduce performance penalties. Such penalties usually emerge from degraded comfort conditions, poor usability and system control, and ultimately operational energy wastage and excessive carbon dioxide emissions.
The flowchart provides a way by which project teams can track and communicate these risks during procurement, ensuring that emerging performance is made visible to key project stakeholders and prospective end-users, from concept, briefing, and detail design stages to project handover and post-occupancy evaluation. Image provided with permission by Roderic Bunn for industry use (copyright retained).
[edit] Expectation types
In management terms, expectations might be categorised by different characteristics, such as.
- Realistic expectations, setting objectives and goals within the scope of a budget, resources, and timelines.
- Unrealistic expectations, setting unachievable goals, depending on the view point, can lead to disappointment.
- Adaptive expectations are goals based on past experiences that may change and adapt.
- Implicit expectations are objectives or goals that are given as accepted or standard within the project.
- Explicit expectations are formalised and standardised for legally stated goals, objectives, or standards.
- Rational expectations, in between the above, are based on common knowledge or industry standards.
[edit] Related articles on Designing Buildings
- Better Buildings Partnership.
- BSRIA Soft Landings Awards.
- Building log book.
- Building performance evaluation.
- Building performance evaluation in non-domestic buildings guide – an introduction to the tests and methods in non-domestic buildings
- Carbon Buzz
- CIBSE Case Study Elizabeth Fry Building.
- Client commissioning.
- Extended aftercare.
- Initial aftercare.
- Lessons learned report.
- Performance gap between building design and operation
- Performance in use of National Trust’s Heelis building and Woodland Trust’s headquarters.
- Post occupancy evaluation.
- Post project review.
- Post-occupancy Review Of Buildings and their Engineering PROBE
- Performance in use.
- Performance of exemplar buildings in use: Bridging the performance gap FB 78.
- Soft landings - helping clients lead contractors.
- Soft landings and business-focused maintenance.
- Soft Landings and Government Soft Landings - A convergence guide for construction projects.
- Soft Landings for owners.
- Specialist commissioning manager.
- Success criteria for soft landings projects.
- Taking action on climate change.
- Technical guide.
Featured articles and news
Future Homes Standard Essentials launched
Future Homes Hub launches new campaign to help the homebuilding sector prepare for the implementation of new building standards.
Building Safety recap February, 2026
Our regular run-down of key building safety related events of the month.
Planning reform: draft NPPF and industry responses.
Last chance to comment on proposed changes to the NPPF.
A Regency palace of colour and sensation. Book review.
Delayed, derailed and devalued
How the UK’s planning crisis is undermining British manufacturing.
How much does it cost to build a house?
A brief run down of key considerations from a London based practice.
The need for a National construction careers campaign
Highlighted by CIOB to cut unemployment, reduce skills gap and deliver on housing and infrastructure ambitions.
AI-Driven automation; reducing time, enhancing compliance
Sustainability; not just compliance but rethinking design, material selection, and the supply chains to support them.
Climate Resilience and Adaptation In the Built Environment
New CIOB Technical Information Sheet by Colin Booth, Professor of Smart and Sustainable Infrastructure.
Turning Enquiries into Profitable Construction Projects
Founder of Develop Coaching and author of Building Your Future; Greg Wilkes shares his insights.
IHBC Signpost: Poetry from concrete
Scotland’s fascinating historic concrete and brutalist architecture with the Engine Shed.
Demonstrating that apprenticeships work for business, people and Scotland’s economy.
Scottish parents prioritise construction and apprenticeships
CIOB data released for Scottish Apprenticeship Week shows construction as top potential career path.
From a Green to a White Paper and the proposal of a General Safety Requirement for construction products.
Creativity, conservation and craft at Barley Studio. Book review.
The challenge as PFI agreements come to an end
How construction deals with inherited assets built under long-term contracts.
Skills plan for engineering and building services
Comprehensive industry report highlights persistent skills challenges across the sector.
Choosing the right design team for a D&B Contract
An architect explains the nature and needs of working within this common procurement route.
Statement from the Interim Chief Construction Advisor
Thouria Istephan; Architect and inquiry panel member outlines ongoing work, priorities and next steps.



























Comments
[edit] To make a comment about this article, click 'Add a comment' above. Separate your comments from any existing comments by inserting a horizontal line.
